Kanban vs Scrum: Which Agile Methodology Is Right for Your Team?
May 22, 2025

Kanban vs Scrum: Which Agile Methodology Is Right for Your Team?

The short answer: Kanban and Scrum are both Agile methods, but they organize work differently. Kanban is a continuous flow system - work moves across a board as capacity frees up, with no fixed iterations, no required roles, and no mandatory meetings. Scrum is an iterative framework - work is planned into fixed-length sprints (usually 2 weeks) with defined roles (Product Owner, Scrum Master, Developers) and a set of recurring ceremonies. Pick Kanban when work arrives continuously and priorities shift often. Pick Scrum when you build complex products in increments and need predictable delivery cadence.

Here is the full comparison at a glance:

AspectKanbanScrum
CadenceContinuous flow, no iterationsFixed sprints, usually 1-4 weeks
RolesNone required, keep your current structureProduct Owner, Scrum Master, Developers
MeetingsOptional (standups, replenishment)Required: planning, daily scrum, review, retrospective
PlanningJust-in-time, pull tasks as capacity freesUp-front per sprint, scope fixed during the sprint
ChangesReprioritize anytimeMid-sprint changes are avoided, wait for next sprint
Key metricsCycle time, lead time, throughputVelocity, sprint burndown
BoardPersistent, never resetsReset at the end of each sprint

That table answers the exam question. The harder question is which one your team should actually run - and that depends on the shape of your work, not on which framework is more popular. The rest of this guide covers both methods in depth, their real pros and cons, and a decision guide we use with teams on t0ggles.

#What Is Kanban?

Kanban

Kanban ("signboard" in Japanese) started in the 1940s at Toyota as a scheduling system for manufacturing, and was adapted for software and knowledge work by David Anderson in the mid-2000s. It is the lightest-weight Agile method there is: you can adopt it in an afternoon without changing job titles, team structure, or your calendar.

Kanban rests on four practices:

  1. Visualize the workflow. Every piece of work is a card on a board, moving through columns like Backlog, To Do, In Progress, and Done. Bottlenecks become visible the moment a column starts piling up.
  2. Limit work in progress (WIP). Each column gets a cap on how many tasks it can hold. This is the practice teams skip most often, and it is the one that makes Kanban actually work - without WIP limits a Kanban board is just a to-do list with extra steps. Our guide to mastering WIP limits covers how to set them.
  3. Manage flow. Instead of asking "is everyone busy?", Kanban asks "is work moving?". You measure cycle time (how long a task takes from start to finish) and work to shorten it.
  4. Make policies explicit. Write down what "Done" means and when a card may move to the next column, so the board stays honest.

The defining mechanic is the pull system: nobody assigns a stack of work up front. When you finish a task, you pull the next one - which means priorities can change right up until the moment someone starts working.

Kanban fits teams whose work arrives continuously and unpredictably: support and ops teams, agencies juggling client requests, freelancers, and maintenance-heavy engineering teams.

#What Is Scrum?

Scrum

Scrum, formalized by Jeff Sutherland and Ken Schwaber in the 1990s, is a framework for building complex products in short, repeating cycles. Where Kanban prescribes almost nothing, Scrum prescribes quite a lot: roles, events, and artifacts that create a rhythm of plan, build, review, adjust.

  • Roles: a Product Owner who orders the backlog by value, a Scrum Master who keeps the process healthy and removes blockers, and the Developers who build the increment.
  • Events: Sprint Planning (what will we commit to this sprint?), the Daily Scrum (a 15-minute sync), the Sprint Review (demo the increment to stakeholders), and the Sprint Retrospective (what do we change about how we work?).
  • Artifacts: the Product Backlog (everything you might build), the Sprint Backlog (what you committed to this sprint), and the Increment (the working product at sprint's end).

The defining mechanic is the timebox: the team commits to a sprint goal, the scope holds for the sprint, and at the end there is something demonstrable. That commit-and-protect cycle is what gives Scrum its predictability - and it is also the source of its overhead. Be honest about the cost: for a two-week sprint, planning, dailies, review, and retro add up to roughly a working day per person. Teams that get value from Scrum earn that day back in focus and fewer mid-week direction changes. Teams that don't are paying a meeting tax for a structure their work never needed.

Scrum fits product teams shipping complex software in increments, teams that need a demo-and-feedback loop with stakeholders, and larger teams that benefit from explicit accountability.

#Agile vs Kanban vs Scrum: What Is the Difference?

This is where most comparisons confuse people, so let's be precise: Agile is not a methodology you can run. It is a set of values - from the 2001 Agile Manifesto - favoring working software over documentation, responding to change over following a plan, and short feedback loops over big up-front design. Kanban and Scrum are two concrete systems for putting those values into practice.

So "Agile vs Kanban" is not a real choice - it's a category and a member of it. The real choices look like this:

  • Kanban vs Scrum: flow-based vs iteration-based. This is the actual decision most teams face, and the rest of this article is about it.
  • Scrum vs Kanban vs Waterfall: Waterfall is the non-Agile option - plan everything up front, execute in phases, deliver at the end. It still makes sense for work with fixed, known requirements (construction, compliance projects), and almost never for software.
  • Other Agile flavors exist too - XP, Lean, Crystal. Our guide to Agile project management and the top 7 project management methodologies cover the broader landscape.

#Is Kanban Agile?

Yes. Kanban predates the Agile Manifesto (its manufacturing roots go back to the 1940s), but modern Kanban as practiced in software teams is fully Agile: it delivers continuously, welcomes changing priorities, and improves through feedback. A team running a Kanban board with WIP limits and regular flow reviews is every bit as Agile as a Scrum team - often more so, since it can respond to change same-day instead of next-sprint.

#Does Kanban Use Sprints?

No. Kanban has no sprints - work flows continuously, and completing one task simply pulls the next. That is the single clearest dividing line between the two methods. If your team is running "sprints" but scope changes freely mid-sprint and nothing is committed up front, you are not really doing Scrum - you are doing Kanban with extra meetings, and you'd likely be happier dropping the sprint pretense entirely (or moving deliberately to the Scrumban hybrid below).

#Kanban vs Scrum: Pros and Cons

#Kanban Pros

  • Almost zero adoption cost. No new roles, no ceremony calendar, no training week. Put your work on a board, set WIP limits, start.
  • Responds to change immediately. New urgent request? It goes to the top of the queue and gets pulled next. No sprint to protect.
  • Exposes bottlenecks. A clogged "In Review" column is visible to everyone, every day.
  • Less meeting overhead. Standups are optional and short - and honestly, a written async standup covers most of what a daily meeting does.

#Kanban Cons

  • No built-in deadlines. Nothing in Kanban forces a delivery date. Teams that need external commitments have to bolt on milestones and due dates themselves.
  • Easy to run badly. Without enforced WIP limits and explicit policies, a Kanban board silently degrades into a task dumping ground.
  • Weaker long-term planning. Just-in-time prioritization is great for flow, but stakeholders asking "what will be done by March?" get vaguer answers than a velocity-based forecast gives.

#Scrum Pros

  • Predictable cadence. Stakeholders know when to expect the next increment and when they get to weigh in. Velocity over a few sprints gives a defensible forecast.
  • Built-in improvement loop. The retrospective is scheduled, not aspirational - every two weeks the team must ask what to fix.
  • Protection from thrash. The sprint boundary is a polite way to say "not this week" to drive-by requests. For teams drowning in interruptions, that boundary alone can justify Scrum.
  • Clear accountability. Product Owner owns priorities, Scrum Master owns process, Developers own the increment. Ambiguity has fewer places to hide.

#Scrum Cons

  • Real overhead. Roughly a day per person per two-week sprint goes to ceremonies. For a team of five, that is a full person-week each month.
  • Rigid mid-sprint. Genuinely urgent work either breaks the sprint or waits. Support-heavy and ops teams break their sprints so often that velocity becomes fiction.
  • Roles need filling. A part-time, absentee Product Owner is the most common way Scrum fails - the backlog rots and planning becomes guesswork.
  • Cargo-cult risk. It is easy to adopt the ceremonies without the substance and end up with "meetings-driven development".

#How to Choose: A Decision Guide

Skip the personality quiz. Work through these questions in order:

1. Does your work arrive continuously, or can it be batched into plannable chunks? Support tickets, client requests, bug flow, content pipelines - continuous. Choose Kanban. Feature development toward a roadmap - batchable. Scrum is on the table.

2. Do priorities genuinely hold for two weeks? Be honest. If leadership reshuffles priorities weekly, a sprint commitment is theater, and Kanban will match reality better. If you can protect a two-week scope, Scrum's predictability pays off.

3. Do you have (or want) a real Product Owner? Scrum without someone actually owning the backlog fails slowly and painfully. No PO in sight? Kanban.

4. How big is the team? For solo makers and teams of 2-4, Scrum's role structure is mostly ceremony - default to Kanban. From about 5 people up, building one product, Scrum's structure starts earning its cost.

5. Do stakeholders need forecasts and demos? If "what will be done by the end of the quarter" is a question you must answer, Scrum's velocity and sprint reviews give you the machinery. If your stakeholders care about response time more than roadmaps, Kanban's cycle time is the better promise.

Summed up:

  • Pick Kanban if: work is continuous or unpredictable, priorities shift often, the team is small, and speed of response matters more than forecasting. Typical: agencies, freelancers, support, ops, maintenance teams.
  • Pick Scrum if: you build a complex product in increments, priorities can hold for a sprint, you have a real Product Owner, and stakeholders need predictable delivery. Typical: product and platform teams of 5+.
  • Pick Scrumban if: you are torn between the two - which usually means your team does both kinds of work.

Whichever you choose, run it for a quarter before judging it. Most "Scrum doesn't work for us" verdicts come from teams that ran it for three chaotic sprints.

#Scrumban: The Hybrid That Often Wins

Scrumban

Plenty of real teams land on Scrumban: Scrum's cadence with Kanban's flow. The common recipe:

  • Keep a persistent board with WIP limits (from Kanban).
  • Keep the retrospective and, if useful, a light planning session (from Scrum).
  • Drop the sprint commitment: work is pulled continuously, but the team still meets on a rhythm to reflect and reprioritize.

It is a natural fit for engineering teams that split time between roadmap features and incoming bugs, and for teams migrating off strict Scrum without losing its good habits. Scrumban is not a cop-out - for mixed workloads it is often the correct answer, not the compromise.

#Running Kanban, Scrum, or Scrumban in t0ggles

t0ggles doesn't force a methodology on you, which is exactly what you want while you're choosing one - or running different methods for different projects on the same board.

For Kanban: the board view gives every project custom statuses with real WIP limits - the column visibly warns when it exceeds its cap, so the limit is a rule, not a suggestion. Because t0ggles puts multiple projects on one board, an agency can run each client's flow side by side without tab switching.

For Scrum: use milestones as sprints, and give each one a name worth remembering with the sprint name generator instead of a bare number. Groom the backlog in list view, drafting stories and acceptance criteria in the user story generator before they land on the board, and track dates on the Gantt chart. Board reports give you burndown and workload without exporting anything. The free standup generator and retro generator cover the two ceremonies teams most want templates for.

For either: AI task creation turns a messy planning note into structured tasks with tags and due dates:

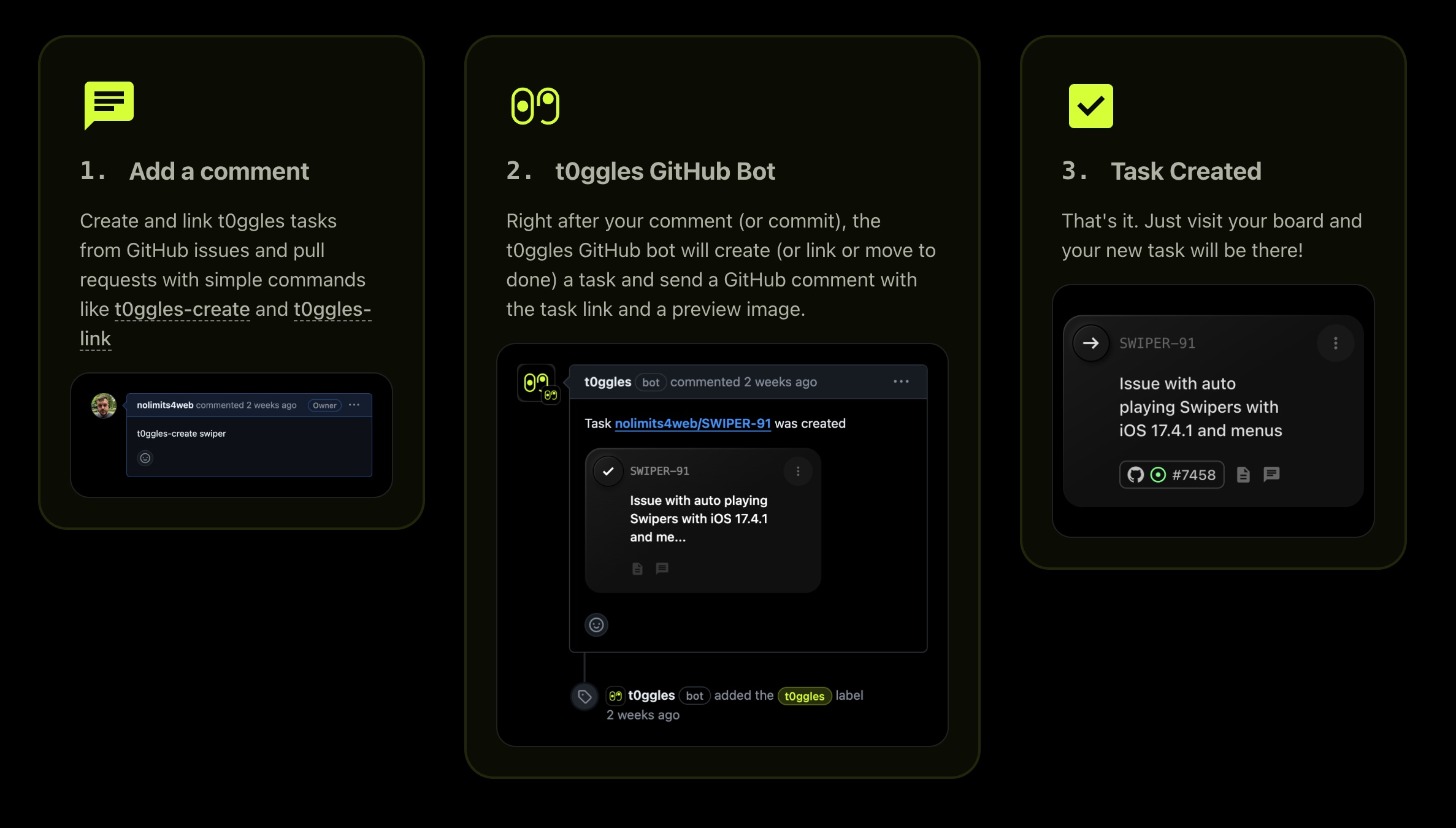

Software teams can wire up the GitHub integration for full two-way sync - issues and PRs become tasks, merged PRs move tasks to Done - which suits both Kanban flow and sprint boards:

GitHub Integration

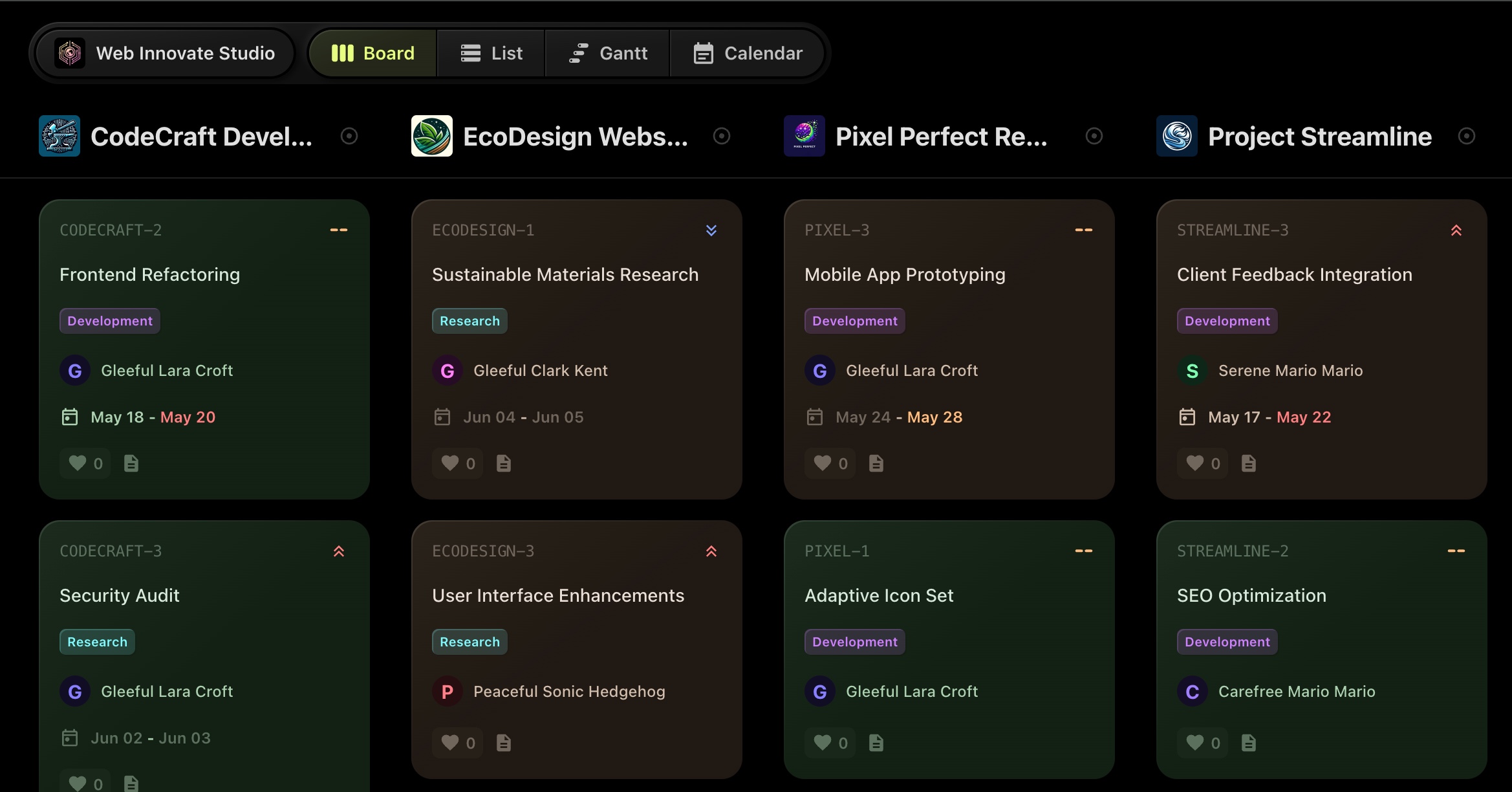

And if clients or stakeholders need visibility, public boards share progress without extra seats:

Public Boards

The free plan includes 1 board, 3 team members, and 100 tasks - enough to pilot Kanban on one project and Scrum on another and see which sticks. The paid plan is $5/user/month (billed annually) with everything unlimited. Dedicated tools like Jira are built Scrum-first and Trello Kanban-first (see our Trello vs Jira comparison); t0ggles deliberately sits in the middle so switching methods doesn't mean switching tools.
